On Thursday, July 23, 2026, Flightradar24 tracked 153,359 commercial flights, the most it has ever recorded in a single day. The number that interests us is a different one: what the fuel for each of those flights costs. That question outlasts the record. It can be answered with technical data and market prices that exist every year.

What a commercial plane actually burns

Not diesel and not gasoline, though it is closer to the first. Commercial aircraft run on aviation kerosene, called Jet A in the United States and Jet A-1 almost everywhere else. Like diesel, kerosene is a middle distillate of crude oil, lighter than diesel and heavier than gasoline.

Its makeup is set by technical standards rather than a single chemical formula: ASTM D1655 in the United States and DEF STAN 91-091 in the United Kingdom. Both regulate freezing point, volatility, thermal stability and additives. The freezing point is where the two fuels differ. Jet A must freeze at -40°F (-40°C) or below, and Jet A-1 at -53°F (-47°C) or below, according to ExxonMobil, one of the major suppliers. The extra margin matters at cruising altitude, where the outside air can reach about -58°F (-50°C).

Which part of the flight burns the most

Not takeoff, even though the engines work hardest there. It is cruise, because it lasts so much longer than everything else.

An analysis by OAG of flights from London Heathrow found that cruise accounted for 96% of the fuel burned on a flight to Hong Kong and 95% on a flight to Dubai. On short flights the share is lower: 68% to Edinburgh and 62% to Paris. Taxiing alone used between 2% and 17% of the fuel, with the highest share on the shortest trips. Takeoff demands the most thrust, but it lasts only a few minutes.

The number that matters most: which aircraft

Fuel cost on any flight comes down to three things: the aircraft, how long it flies and the price of fuel that week. According to technical data compiled by the industry publication Aircraft Commerce, an Airbus A320, the most widely used single-aisle jet, burns about 2.5 tonnes of fuel an hour. A Boeing 777, built for long haul, burns 7 to 8 tonnes. An Airbus A380, the largest passenger jet in service, burns 11 to 12 tonnes.

What a short flight costs against a long one

For the price, we use IATA’s Jet Fuel Price Monitor, which publishes a weekly global average with S&P Global Platts. In the week ending July 17, 2026, it stood at $149.40 a barrel, according to IATA data reported by Forbes. A barrel holds 42 gallons, so that is about $3.56 a gallon.

At that price:

FlightFuel burnedEstimated fuel cost
Airbus A320, 2.5 hours (Madrid to London)6.25 tonnes, about 2,060 gallonsAbout $7,340
Boeing 777, 8 hours (Madrid to New York)60 tonnes, about 19,800 gallonsAbout $70,400
Airbus A380, 12 hours138 tonnes, about 45,500 gallonsAbout $162,000
Chart: estimated fuel cost per flight at $149.40 a barrel, about $7,340 for a 2.5-hour Airbus A320 flight, $70,400 for an 8-hour Boeing 777 flight and $162,000 for a 12-hour Airbus A380 flight.

These are our own calculations, for fuel alone, before crew, maintenance or airport fees. No airline publishes its fuel cost flight by flight, and route, payload, wind and altitude all change real consumption.

Fuel cost per kilogram of aircraft

Another way to compare them is to divide each flight’s fuel cost by the aircraft’s maximum takeoff weight, which Airbus and Boeing publish for every model. An A320, at about 78,000 kilograms, comes to about $0.09 per kilogram on its short flight. A Boeing 737-800, at 79,015 kilograms and a similar cost, also comes to about $0.09. A Boeing 777-300ER, at 351,500 kilograms, comes to about $0.20 on its long flight. An A380, at 575,000 kilograms, comes to about $0.28.

The bigger the aircraft and the longer the flight, the more the fuel costs relative to the plane’s weight. That makes sense: on a long flight, a large share of that maximum weight is the fuel itself.

Why the price is not the same everywhere

Jet fuel prices vary by region with access to crude, local refining capacity, taxes and the cost of delivering fuel to each airport. The United States has its own benchmark, the Gulf Coast spot price published by the Energy Information Administration. In 2025 it averaged $2.114 a gallon, slightly below IATA’s global average of $90 a barrel, about $2.14 a gallon. The same flight can cost a different amount depending on where the aircraft refuels.

How the price has moved since 2019

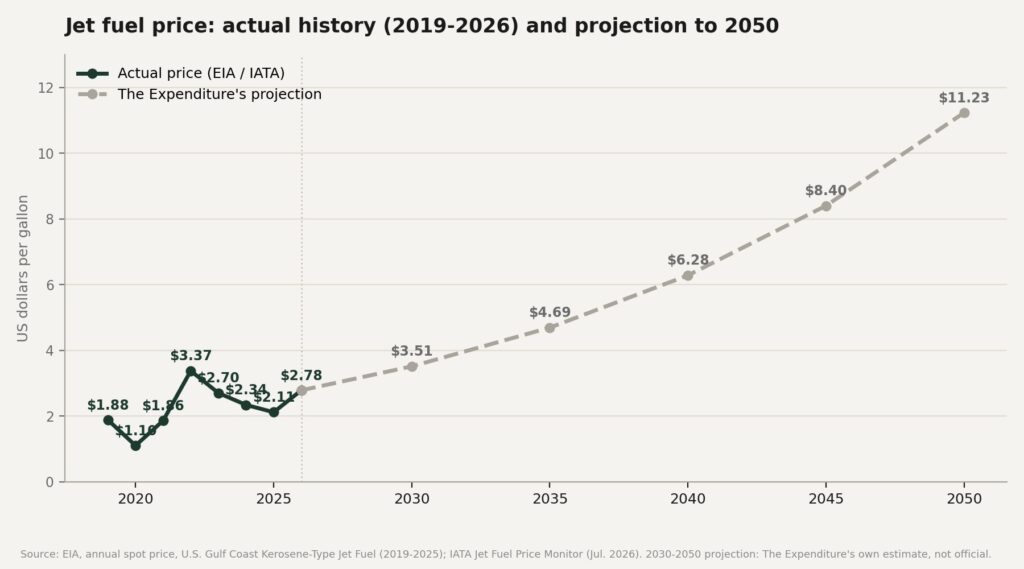

The EIA’s Gulf Coast series shows how far from a straight line the price runs:

YearUS Gulf Coast jet fuel, dollars per gallon
20191.879
20201.099
20211.858
20223.374
20232.699
20242.338
20252.114
June 20263.042

The price fell by 42% in the first year of the pandemic, tripled by 2022, eased for three years and then jumped again in 2026. Any average annual rate drawn from that series would hide more than it shows.

Why 2026 has been so volatile

The conflict that began on February 28, 2026 between Israel, the United States and Iran effectively closed the Strait of Hormuz, the route for about a fifth of the world’s oil consumption, according to the EIA. IATA’s global jet fuel price reached $209 a barrel in the week ending April 3. A ceasefire followed on April 8, and by the week ending June 5 the price had fallen to $146.25. In July, with the conflict flaring again, it rose 18% in a single week, to $149.40.

That is why the same flight can cost very different amounts depending on the week: at April’s peak, the A380 flight in our table would have cost about $227,000 in fuel.

Why this matters beyond curiosity

Fuel is the largest single cost for airlines. IATA expects it to make up 31.4% of the industry’s operating costs in 2026, up from 25.4% in 2025. The fuel bill is forecast at $351 billion, against $252 billion in 2025, and above the $271 billion airlines will spend on labor.

Airlines do not absorb that. IATA expects passenger revenue to rise 9.2% in 2026, to $839 billion, while traffic grows only 2.1%: the increase comes from fares, not from more passengers. It also explains the push for efficiency. Airbus says its A320neo burns about 20% less fuel per seat than the previous generation, and in a business where fuel is the biggest expense, that difference goes straight to the margin.

Frequently asked questions

What fuel do commercial planes use?

Aviation kerosene: Jet A in the United States and Jet A-1 elsewhere, made to the ASTM D1655 and DEF STAN 91-091 standards.

Which phase of a flight burns the most fuel?

Cruise, because it lasts longest: 95% to 96% of the fuel on the long-haul flights OAG analyzed, and 62% to 68% on short ones.

How much does the fuel for a commercial flight cost?

At July 2026 prices, about $7,340 for a 2.5-hour A320 flight, about $70,400 for an 8-hour Boeing 777 flight and about $162,000 for a 12-hour A380 flight, by our calculation.

How much does it cost to fill an A380?

Its tanks hold about 320,000 liters. At $3.56 a gallon, a full load would cost about $300,000, though aircraft rarely take off with full tanks.

Why did jet fuel prices rise so much in 2026?

Because of the effective closure of the Strait of Hormuz after the conflict that began in late February. IATA's global price peaked at $209 a barrel in early April.

What share of an airline's costs is fuel?

31.4% of the industry's operating costs in 2026, according to IATA, more than labor.

Notes. All figures are in US dollars. Fuel costs are our calculations: hourly burn rate multiplied by flight time, converted at about 3.03 kilograms per gallon and priced at $149.40 a barrel (42 gallons), the IATA global average for the week ending July 17, 2026. The April comparison uses $209 a barrel. The full-tank figure converts 320,000 liters at 3.785 liters per gallon. Cost per kilogram divides each flight’s fuel cost by the manufacturer’s maximum takeoff weight. IATA’s 2025 average of $90 a barrel equals about $2.14 a gallon.
