Record Data Sheet

Amount
$1,3B
Entity
Carolina Panthers, Tepper Sports & Entertainment, City of Charlotte
Confirmed
July 23, 2026

Ask how much of Bank of America Stadium’s renovation Charlotte taxpayers are covering and you’ll get two very different answers, both defensible, both drawn from the same city council document. One says 81%. The other says roughly half. Neither is wrong. They’re just measuring different slices of the same deal.

What the city’s own document actually says

In June 2024, Charlotte’s city council approved $650 million in public funding for stadium modernization, drawn from hospitality and tourism taxes, in a vote where three of eleven council members dissented over how the deal had been presented to them. That $650 million figure hasn’t moved since.

Tepper Sports & Entertainment’s side of the ledger is where things get harder to pin down with a single number. The city’s own June 2024 presentation breaks TSE’s commitment into three pieces: $117 million already spent between 2018 and 2024, $150 million earmarked for modernization and cost overruns during the main 2025 to 2029 construction window, and roughly $421 million in projected capital improvements and operations through 2045. Addall three and TSE’s total comes to about $688 million. Compare only the middle figure, the $150 million tied to the same 2025 to 2029 window as the city’s spending, and TSE looks like the smaller partner by a wide margin.

So which number is the honest one

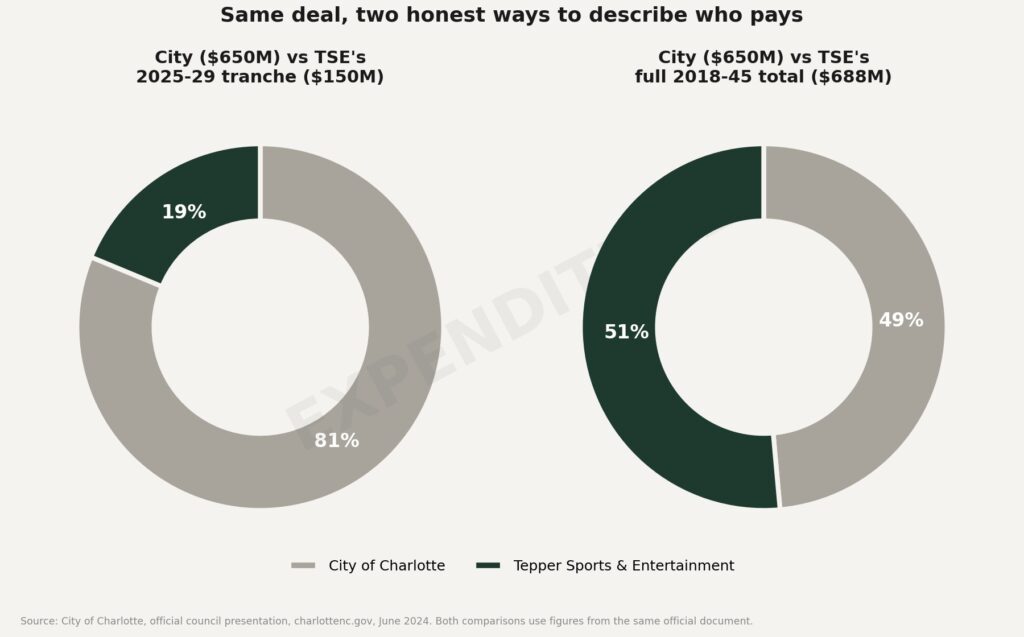

Neither, on its own. Set the city’s $650 million against TSE’s $150 million construction- window figure and public funding covers 81% of that slice. Set the same $650 million against TSE’s full $688 million, spanning nearly three decades of spending, and the split lands close to even.

This is the part worth sitting with less as a gotcha and more as a pattern. Large infrastructure deals almost always contain a short-term construction tranche and a much longer operating or maintenance tail. Whoever is presenting the deal gets to choose which one to lead with, and that choice alone can shift a headline from “the public pays 81%” to “it’s basically a 50/50 partnership,” using figures that were never in dispute to begin with.

A separate detail circulating about a new $500 million

Some coverage in 2026 described Tepper Sports & Entertainment committing an additional $500 million on top of the original deal, pushing the total project value toward $1.3 billion. A North Carolina State Auditor’s office review from around the same period referenced TSE matching the city’s contribution with “just over $668 million.” Neither figure lines up cleanly with the $688 million already laid out in the 2024 document, and this publication was not able to locate a standalone Tepper Sports & Entertainment press release stating a discrete new $500 million commitment with the same level of detail the 2024 city presentation provides. It’s possible this reflects the $421 million long-term estimate becoming a firmer commitment over time rather than genuinely new money. Until a primary document resolves that gap, treat the $1.3 billion total as directionally consistent with the original plan rather than confirmation of fresh capital.

Who actually owns the downside

Whatever the exact figure, the structural detail that holds up across every version of this story is who absorbs cost overruns. The city’s own document assigns that risk to TSE, not to Charlotte. If construction costs run over budget during the 2025 to 2029 window, TSE’s obligation grows. The city’s $650 million does not.

That asymmetry matters more than the funding ratio does. A 50/50 split where one party eats all the overrun risk isn’t really a 50/50 arrangement in economic terms, even if it is one in accounting terms.

The 2037 clause

A separate provision in the 2024 agreement sets 2037 as the target year for the city and TSE to begin discussing an entirely new stadium, with completion envisioned by 2046, when the current building turns 50. A city spokesperson has called this aspirational rather than binding. Whatever its legal weight, it means the renovation on the table now was negotiated alongside an acknowledgment that it might not be the last word.

Why this deal drew criticism before any of these later numbers surfaced

The Center for Economic Accountability, a nonprofit watchdog group, named Charlotte’s original $650 million commitment its “Worst Economic Development Deal” of 2024, pointing to how the agreement moved through council and questioning its economic justification. That criticism landed before any of the $500 million or $668 million figures entered the conversation, which suggests the more recent numbers are complicating an already contested deal rather than resolving it.

Why we consider this relevant

The lesson here travels well beyond one NFL stadium. Big capital commitments rarely reduce to one clean number, and whoever controls the framing controls the headline. Charlotte’s stadium deal can be fairly described as heavily public or roughly balanced, depending entirely on which years and which TSE obligations get counted. Anyone evaluating a public-private capital project owes themselves the same exercise: find the full time horizon, find who owns the overrun risk, and only then decide which ratio actually describes the deal.

Frequently asked questions

How much is the City of Charlotte paying toward Bank of America Stadium?

$650 million, funded through hospitality and tourism taxes, approved by city council in June 2024. This figure has not changed in subsequent reporting.

How much is Tepper Sports & Entertainment paying?

It depends on the time frame. The city’s own 2024 document lists $150 million for the 2025 to 2029 construction window and roughly $688 million when spending from 2018 through 2045 is included.

Did Tepper Sports & Entertainment really add $500 million in new money?

Reporting from 2026 describes this, and a state auditor’s review references TSE matching the city
with “just over $668 million.” This publication could not locate a standalone official release confirming a discrete new $500 million commitment separate from the long-term figures already in the 2024 agreement, so that detail should be treated cautiously.


Who pays if construction costs run over budget?

Tepper Sports & Entertainment, according to the city’s official 2024 presentation, which assigns cost overrun risk to TSE rather than the city.


Sources

City of Charlotte, official council presentation on Bank of America Stadium funding, charlottenc.gov, June 2024

North Carolina Office of the State Auditor, review referencing Tepper Sports & Entertainment’s matching contribution, 2026
