Record Data Sheet
On August 17, 2026, Canadian Prime Minister Mark Carney stood in St. John’s, Newfoundland and Labrador, alongside the premiers of Newfoundland and Labrador and Quebec, and announced up to $10 billion in federal financial support toward what the government is calling the largest clean energy investment in North American history, a package of projects it values at nearly $70 billion, according to the Prime Minister’s official release. The spending decision underneath the headline is more interesting than the number itself: Ottawa is putting public capital behind unwinding one of the most one-sided long-term contracts in Canadian corporate history.
What the federal government is actually paying for
The $10 billion federal commitment funds four things, according to the official release: upgrading and expanding the Churchill Falls Generating Station, developing the long- delayed Gull Island hydroelectric project, building new transmission lines, and a 2,000megawatt onshore wind project in Labrador. The financing is structured as a guarantee, Ottawa backstopping the debt that makes the rest of the roughly $70 billion in construction economically financeable for the two provincial utilities involved, Hydro-Québec and Newfoundland and Labrador Hydro.

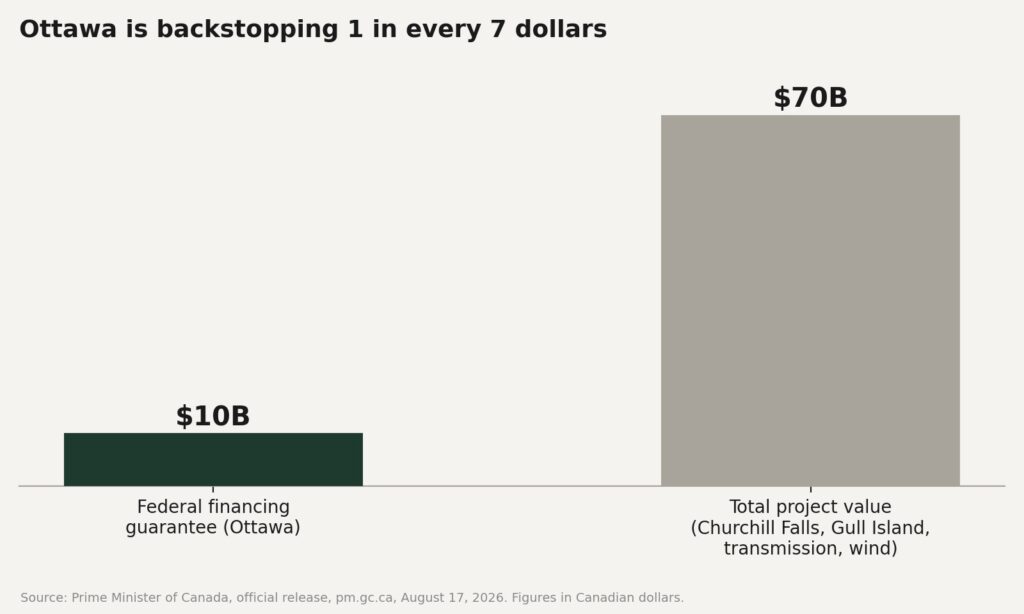

That structure matters for how to read the number. Ottawa isn’t writing a $70 billion check. It’s providing roughly $10 billion in financing support, about one dollar of federal backing for every seven dollars of total project value, to unlock private and provincial utility capital that likely would not move at this scale, or at this cost of capital, without a federal guarantee underneath it.
Why this deal needed a government to show up at all
The commercial logic runs through the 1969 Churchill Falls Contract, one of the most studied bad deals in Canadian business history. Under that original agreement, Quebec locked in the right to buy the vast majority of Churchill Falls’ power at a fixed, ultra-low price for 65 years, a rate that never adjusted for inflation or rising market power prices. Hydro- Québec has earned tens of billions of dollars in profit reselling that power at market rates over the decades, while Newfoundland and Labrador, which owns the generating asset, received a small fraction of that value. It is the textbook case taught to explain why long- duration contracts without renegotiation clauses or price indexing can transfer enormous value away from the party that appears, on paper, to own the asset.
Today’s announcement is enabled by what the two utilities call a Definitive Cooperation and Implementation Agreement, which terminates and replaces both the original 1969 contract and a 2024 memorandum of understanding that had already attempted a partial fix, according to the joint statement from Hydro-Québec and Newfoundland and Labrador Hydro. Reporting from CBC News and BNN Bloomberg describes the broader package, including the wind project specifics, as a tentative, non-binding framework rather than a fully executed final agreement, even as the federal government’s own release frames the financing commitment in firmer terms. That distinction, between what has actually been signed and what has merely been announced, is the detail worth tracking as this deal moves toward completion.
The part of the spending that looks toward the next contract dispute
Alongside the energy financing, the government referred what it calls the Labrador Trough Clean Power, Critical Minerals and Infrastructure Corridor to Canada’s Major Projects Office, a body created to coordinate financing and permitting for large national projects, and committed separate funding through its First and Last Mile Fund for early stagedevelopment work in the region, according to the official release. The Labrador Trough holds substantial high purity iron ore deposits, so pairing new clean power capacity with new transmission and critical minerals infrastructure is a deliberate sequencing decision: build the power first, so the mining investment that follows doesn’t stall waiting for electricity the way many critical minerals projects elsewhere have.
Why the financing structure is the real signal for anyone underwriting Canadian infrastructure risk
A government guarantee is, functionally, a transfer of risk from private lenders and utility balance sheets onto the federal government’s own credit. For a $70 billion, multi-decade infrastructure buildout spanning hydroelectric, transmission, and wind assets, that guarantee is what makes the financing cost workable at all. It also means the eventual price tag to Canadian taxpayers depends entirely on execution, cost overruns, delays, and interest rate movements over a build-out that will likely span a decade or more, none of which are fixed by today’s announcement.

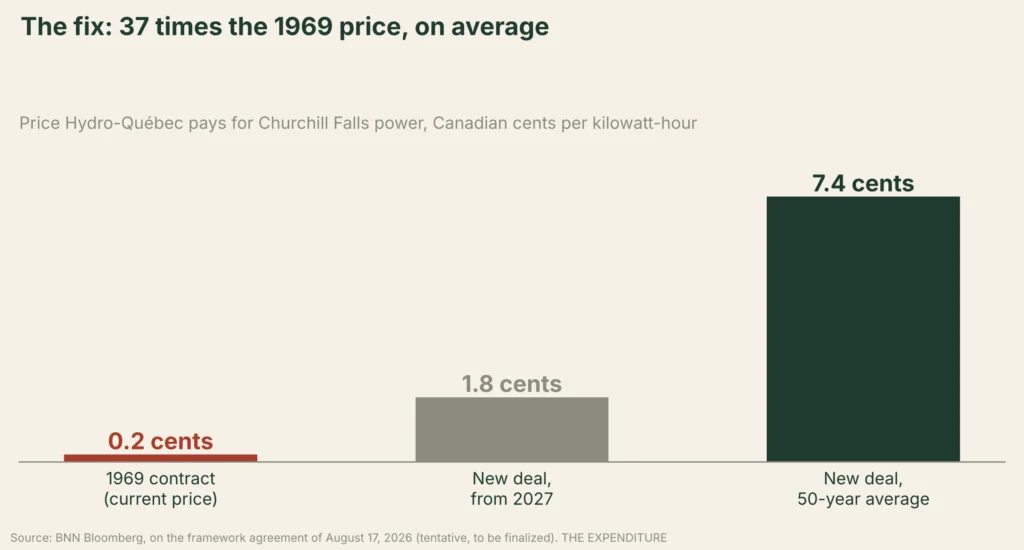

The project’s own precedent is the caution here. The original Churchill Falls development in the 1960s also looked, at signing, like a well structured deal for both sides. It became one of the most lopsided contracts in North American corporate history because nobody priced in six and a half decades of inflation and market change. Whether this new package avoids repeating that outcome depends less on the $10 billion headline figure and more on whether the underlying agreements, once finalized, include the kind of price adjustment and renegotiation mechanisms the 1969 contract conspicuously lacked.
Why we consider this relevant
It’s not just that this is a $10 billion headline. It reveals something about how Canada is starting to structure public spending on critical infrastructure: instead of funding projects directly, the federal government is acting as a guarantor, multiplying its capital mobilization power roughly sevenfold without putting the full amount on its own balance sheet. That’s a template likely to reappear across other energy, critical minerals, and infrastructure projects in the years ahead, not a one-off structure.
It’s also a rare, concrete reminder that very long-duration contracts without review or price- adjustment clauses can cost one side decades of lost value. That’s a lesson worth keeping in mind for anyone negotiating multi-year supply agreements, leases, or offtake contracts, not just for the two utilities involved here.
Frequently asked questions
How much is Canada’s federal government spending on this deal?
Up to $10 billion in financing support, part of a combined package the government values at nearly $70 billion, according to the Prime Minister’s official release on August 17, 2026.
What is the federal money actually funding?
Upgrading and expanding the Churchill Falls Generating Station, developing the Gull Island hydroelectric project, building new transmission lines, and a 2,000 megawatt onshore wind project in Labrador, according to the official announcement.
Is this a final, signed agreement?
Partially. The two utilities have signed a Definitive Cooperation and Implementation Agreement covering the core Churchill Falls arrangement, but reporting from CBC News and BNN Bloomberg describes elements of the broader package, including the wind project, as a tentative framework still subject to further steps.
What was wrong with the original 1969 Churchill Falls contract?
It locked Newfoundland and Labrador into selling the vast majority of the plant’s power to Quebec at a fixed, ultra- low price for 65 years with no inflation adjustment, allowing Hydro-Québec to earn far more reselling that power at market rates than Newfoundland and Labrador earned generating it.
How much power could eventually reach the United States under this deal?
Up to 985 megawatts transmitted through Quebec to US markets, according to reporting on the
framework agreement, separate from the broader 14,000 megawatts of new and existing
hydroelectric development utilities are evaluating in the region.
Why is critical minerals development mentioned in an energy financing announcement?
Because the Labrador Trough region holds significant high purity iron ore deposits, and the government is sequencing new power and transmission capacity ahead of the mining investment that would depend on it, referring the corridor to its Major Projects Office for coordinated financing and permitting.
